← All modules
Module · Simulate

Balance every line to takt. And keep it there.

Line balancing uses live production data to find your bottleneck, test millions of ways to redistribute work, and recommend the rebalance that gets the most out of the line you already have.

Up to 8%
more output from the same line.
In the product

Flagged bottleneck, per-station load and the solver's recommended rebalance.

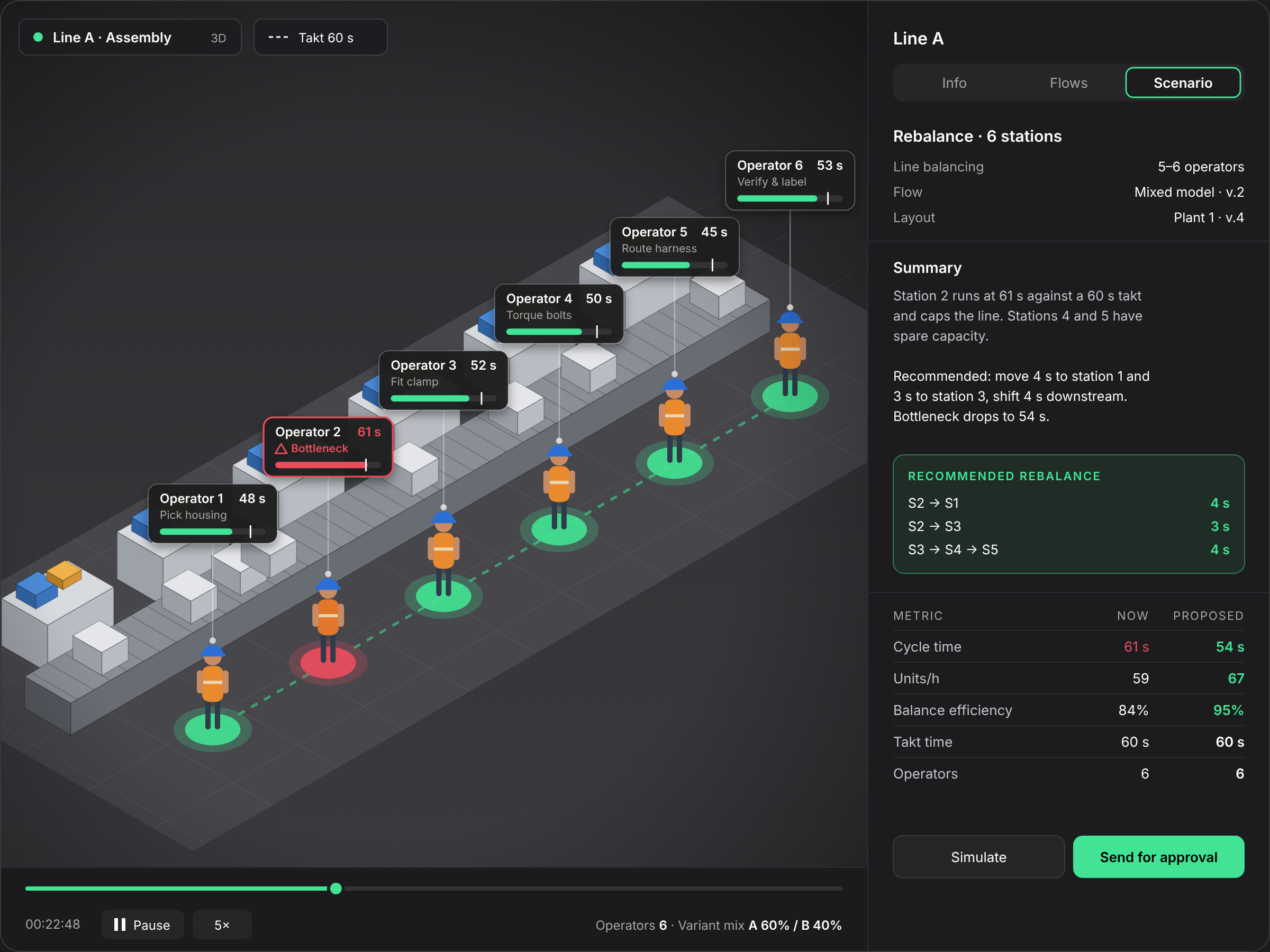

Line balancing scenario view: six operators along an assembly line, station 2 flagged as the bottleneck at 61 seconds against a 60 second takt, and a solver panel recommending a rebalance that cuts cycle time to 54 seconds and lifts output from 59 to 67 units per hour
The problem

Balanced once. Drifting daily.

Most lines are balanced well exactly once: at launch. After that, product mix, operator skills, micro-stops and engineering changes shift work between stations. One station creeps past takt, the whole line slows to its pace, and the others wait.

Rebalancing by hand takes weeks or days of time studies and spreadsheets, so most lines run with the bottleneck until the next kaizen event.

Questions it answers

“Where is the current bottleneck, and what happens if we move it?”

“How does a new product variant change the balance?”

“What's the fastest this line can run with four operators?”

Before and after

Same work. Better spread.

Bottleneck
61 s
Slowest station sets the pace
Balance efficiency
84%
309 s of work ÷ (6 × bottleneck)
Output
baseline
Same people and equipment

Six stations, 309 seconds of work, takt 60 seconds. Before: station 2 runs at 61 s and caps the line (84% balance efficiency). After: the bottleneck drops to 54 s (95% efficiency), giving about 13% more output with the same people and equipment.

Capabilities

Built for industrial engineers

Precedence-aware

Respects task order, zoning and fixed-station constraints.

Mixed-model

Balances across variants and real product mix, not just the average model.

Takt scenarios

Re-plan in minutes for new demand, shift patterns or headcount.

What-if simulation

Test every move before it touches the line.

How it works

STEP 1

Connect or add manually.

We pull task times, task order, variants, staffing and demand from MES, ERP, PLCs and time studies. Your systems stay as they are.

STEP 2

Optimize.

The solver tests millions of ways to assign tasks to stations against takt, precedence, mix, skills and ergonomics. The best options are simulated against real variation.

STEP 3

Approve and act.

Your engineers review ranked proposals, adjust them and approve. Nothing changes on the line without that sign-off.

What we need to get started

Line balancing is a module on the Epicz platform. Connections set up for it are reused by every other module.

  • Task list with times (time studies or MES data, even if outdated)
  • Task order and any fixed-station constraints
  • Variants and planned mix
  • Read access to MES / ERP / PLC, or exports to begin with or manual data added
Compared with today's methods

Why not a spreadsheet?

Spreadsheet / Yamazumi
Line-balancing software
Simulation study
Epicz line balancing
Uses live line data
No
No
Partly
Yes
Mixed-model
No
Partly
Yes
Yes
Tested before the line changes
No
Partly
Yes
Yes
Time to rebalance
Weeks
Days
Weeks
Hours

For a single-model line with stable demand, a spreadsheet may be enough. The more variants, mix changes and lines you run, the faster a static balance decays.

Customer proof

Tier-1 Automotive Supplier

30%
more efficient
10M€
bottom line effect
<30 min
to complete a full LB
“
“Epicz Line Balancing turns a time-consuming exercise into continuous optimization, allowing for rapidly identifying optimal configurations, uncovering scenarios teams may not have considered, and continuously improving performance on every line.”

Tier-1 automotive supplier

Pilot

Start with one line

An 8-week pilot on a single line, measured against KPIs we agree up front: output per hour, idle time and balance efficiency. Clear go/no-go at week 8.

Book a pilot scoping call →
Weeks 1–2

Baseline.

Connect data, map tasks and measure today's balance.

Weeks 3–5

Optimize.

Simulate scenarios and deliver a ranked rebalance plan with your engineers.

Weeks 6–8

Prove.

Implement on the line and measure the result.

You bring
one line and a process owner.
We commit
agreed KPIs and a clear decision point.

Frequently asked questions

Do you replace our MES?
+

No. We connect to MES, ERP and PLCs and read the data we need. Your systems stay as they are.

Our time studies are outdated. Can we still start?
+

Yes. We baseline with what you have and refine the times with live line data during the pilot.

Does it handle mixed-model lines?
+

Yes. It balances across variants and your real product mix, not just an average model.

Who decides what changes on the line?
+

Your engineers. Every proposal is simulated and explained, and nothing is rolled out without their approval.

How long until we see a result?
+

A ranked rebalance plan within the first five weeks of a pilot, and a measured result by week 8.

What does it cost?
+

Fixed-price pilot; contact us.

White paper

Line balancing that stays balanced

Why continuous, AI-driven line balancing outperforms spreadsheets, rule-of-thumb methods and one-off simulation studies.

Email required. PDF · 3 pages · 143 KB

Thanks. Your copy of the white paper is ready.

Download PDF

PDF · 3 pages · 143 KB

Something went wrong. Please check your email address and try again.

Cover of the Epicz Lab white paper Line balancing that stays balanced

More in Simulate
